News

Why Full Order Books Can Hide Shipyard Cashflow Problems

July 20, 2026 Shipyard

A full order book can make a shipyard look financially secure, but contracted work is not the same as available cash. This article examines how payment timing, cost overruns, delays and rapid growth can place even very busy yacht builders under pressure.

A full order book is one of the most reassuring things a shipyard can show the outside world. The sheds are full, cranes are moving, hulls are lined up in various stages of construction and delivery slots may be unavailable for several years. At boat shows, the yard talks about new contracts, expanding facilities and the growing size of its future fleet. For owners considering where to build, this can look like the clearest possible evidence of financial strength. A yard with hundreds of millions of euros of yachts under contract surely cannot be short of money.

Yet it can.

That apparent contradiction sits at the heart of one of the least understood risks in superyacht construction. A shipyard can be extraordinarily busy and still face severe cashflow pressure because an order book is not the same thing as cash in the bank. It represents work that has been sold, often years into the future, while the money needed to build those yachts has to move through the business every day. Employees have to be paid, subcontractors expect their invoices settled, engines and generators require deposits, steel and aluminium must be purchased, designers continue working and hundreds of suppliers have their own payment schedules. A yacht contract may be worth €50 million, €100 million or considerably more, but that does not mean the shipyard receives that amount when the agreement is signed.

The owner normally pays in stages as construction progresses. There may be an initial deposit followed by instalments connected to contractual milestones such as the start of construction, completion of the hull, machinery installation, launch and final delivery. On paper this looks perfectly balanced: the yacht progresses, another payment arrives and the yard uses that money to continue the build. In reality, construction rarely develops in such a neat financial sequence. A major supplier may demand a large deposit long before the owner's next instalment is due. Engines may have to be ordered years in advance. Interior contractors may require substantial advance payments to secure production capacity. The shipyard may therefore be spending millions on a project before the contract allows it to collect the next millions from the owner.

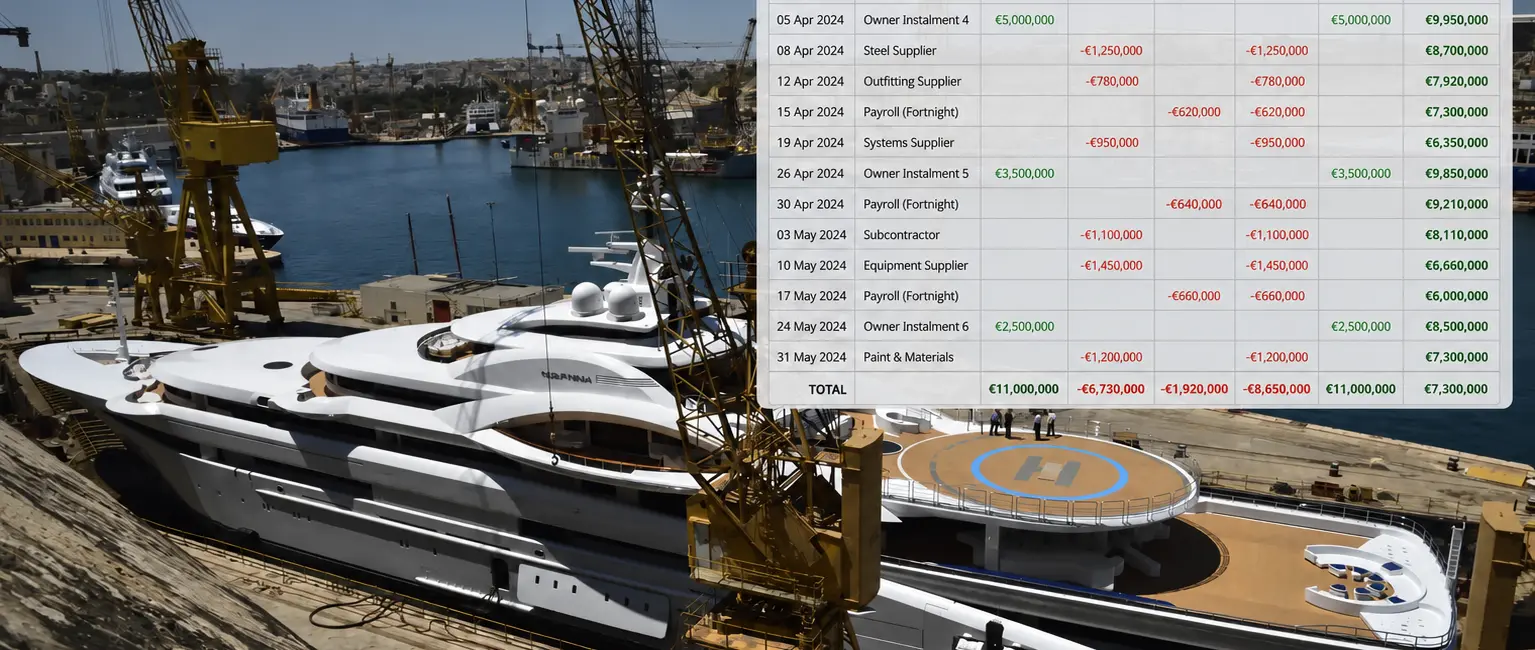

That gap is where cashflow becomes critical.

A financially strong yard can absorb those differences through its own capital, banking facilities and careful management of working capital. Problems begin when several yachts demand large amounts of money at the same time. One project may be paying for main engines while another enters the labour-intensive interior phase and a third requires expensive subcontractor work before launch. Meanwhile, the entire organisation continues consuming cash every month regardless of whether an owner milestone happens to fall due. Salaries, energy, insurance, rent, financing, security, administration and the cost of maintaining the shipyard itself do not pause between contractual payments.

This means something counterintuitive can happen when a successful shipyard grows quickly: the more yachts it sells, the more cash it may need.

A yard accustomed to building four yachts simultaneously may suddenly have eight under construction. Commercially, this looks like spectacular growth. Financially, it can require a huge increase in working capital before the additional projects produce any meaningful profit. More yachts mean more people, more subcontractors, more equipment orders, more warehouse space and more money tied up in work that has not yet reached the next payment milestone. If growth is faster than the business's ability to finance it, a full order book can become a burden rather than a protection.

The danger is particularly difficult to see from outside because the shipyard still looks prosperous. Visitors see yachts being built, employees working and new projects arriving. Launches continue. Marketing continues. Boat-show stands remain impressive. There may be no obvious sign that the financial pressure underneath all that activity is increasing.

This is why profitability and cashflow have to be understood as two different things. A yacht may appear profitable across its full construction period because the contract price is higher than the estimated total cost of building it. But that does not mean the money arrives at the same time as the bills. A shipyard may expect to make several million euros of profit when a yacht is delivered and still struggle to finance the two or three years required to reach that point. Profit that exists on a spreadsheet at the end of a project cannot pay a supplier whose invoice is due this Friday.

The position becomes more dangerous when costs begin to move away from the assumptions made when the yacht was originally sold. Superyachts take years to build, and those years create opportunities for almost everything to change. Materials become more expensive, wages rise, specialist equipment costs more than expected and subcontractors revise their prices. Owners alter specifications and designers refine details. Some changes are properly treated as paid variations, but not every additional cost can be passed on. Technical problems occur, work has to be repeated and schedules slip.

A delay is not simply an inconvenience to the owner waiting for delivery. Every additional month can cost the shipyard money. The yacht continues occupying valuable construction space, project managers remain assigned to it, temporary systems stay in place and subcontractors remain involved. The next yacht may not be able to enter the shed when planned, which then disrupts another project and another payment schedule. What begins as a technical delay on one yacht can gradually become a financial problem affecting several.

This is particularly painful when the original build contract was priced aggressively.

A shipyard may win an attractive project by offering a competitive fixed price, perhaps during a period when costs appear relatively stable. Three years later the economic environment may look very different. If the contract does not allow those increases to be passed to the owner, the yard absorbs them. The yacht is still worth the same contractual amount, but everything required to build it has become more expensive. A project that initially promised a healthy margin can gradually become marginal, and in extreme circumstances the remaining money due from the owner may barely cover the remaining cost of completing the yacht.

At that point, something that appears valuable in the order book can actually become financially dangerous.

This is one of the reasons the headline value of a shipyard's order book tells surprisingly little about the underlying health of the business. Two yards might each have €500 million of contracted work, yet those order books could be completely different financially. One may contain carefully priced yachts with realistic schedules, strong margins and sensible payment structures. The other may be filled with ambitious fixed-price projects sold cheaply in order to secure market share, each carrying technical risk and little room for cost increases.

From the outside, both yards can announce exactly the same number: €500 million.

Only one may be financially comfortable.

The most serious problems begin when cash intended for one project starts solving problems created by another. Imagine an older yacht has suffered significant overruns. Suppliers are waiting for payment, construction is behind schedule and the remaining owner instalments are not enough to comfortably cover everything still required. Then the shipyard signs a new yacht and receives a substantial initial deposit.

The arrival of that money immediately improves liquidity.

There is a temptation to use part of it to pay overdue suppliers on the older project and keep that yacht moving towards delivery. Initially, this may appear entirely manageable because the new yacht has barely begun and will not require its heaviest expenditure for some time. The problem has not disappeared, however. It has simply moved from the older yacht to the newer one. When the new project eventually requires the money that should have been reserved for it, the yard needs another source of cash.

Perhaps another contract is signed.

Another deposit arrives.

Another gap is filled.

The order book becomes larger and the shipyard appears increasingly successful, while the business becomes progressively more dependent on winning new work simply to support work already underway.

That is the point at which an apparently healthy order book can become dangerously misleading.

No responsible outsider should assume that every busy yard operates this way. Most established builders manage project funds, working capital and financing responsibly, and staged payments are a normal part of yacht construction. The risk lies in the fact that the same outward appearance can exist in both a financially strong yard and a financially stressed one. The sheds can be equally full.

Often the first people to notice the difference are not owners at all. They are suppliers.

A subcontractor accustomed to receiving payment after 30 days may begin waiting 45, then 60, then 90. The shipyard may request longer credit terms or ask suppliers to delay invoices until the next owner payment arrives. Equipment manufacturers that once supplied on normal commercial terms may begin asking for larger deposits before starting work because they are concerned about exposure.

That makes the cashflow problem worse. A strong yard may be allowed generous payment terms because suppliers trust it. A yard whose suppliers have become nervous may have to pay earlier, meaning even more cash is required before the project reaches the next owner milestone.

Eventually the effects may begin to reach the yacht itself. A supplier refuses to release equipment until an outstanding balance is settled. A subcontractor reduces the number of workers assigned to the project. Progress slows without any obvious technical reason. The owner sees deadlines starting to move, while the underlying financial problem may have started many months before.

This is why the physical appearance of a shipyard is such a poor measure of financial strength. Ten yachts under construction do not automatically indicate a stronger business than three yachts under construction. The yard with three may have substantial cash reserves, conservative pricing and shareholders willing to provide capital when needed. The yard with ten may be stretched to the limit of its facilities, dependent on owner payments arriving precisely on schedule and carrying very little margin for unexpected costs.

For someone commissioning a new yacht, that distinction matters because the owner is not simply waiting to buy a finished product. During construction, the owner is normally funding the project through staged payments. Millions of euros may have been transferred years before delivery. Those payments help finance materials, labour and equipment as the yacht progresses.

That makes the financial health of the builder part of the owner's risk.

The relevant question is therefore not simply whether the shipyard has built beautiful yachts in the past or whether respected owners have placed new orders. It is what happens to the buyer's money during construction and what protections exist if something goes wrong. Depending on the contract and jurisdiction, those protections may include bank guarantees, refund guarantees, rights over work in progress, title to materials or equipment and carefully structured payment milestones. The exact arrangements vary enormously, but the underlying principle is the same: an owner should not assume that a famous name or a full production schedule automatically protects the project.

Financial due diligence may be far less exciting than choosing an exterior designer or discussing the beach club, but it can be just as important.

A buyer and their advisers should want to understand who ultimately owns and supports the shipyard, whether recent accounts show a financially stable business, how heavily the yard is indebted and whether its current order book appears realistic for its actual production capacity. They should pay attention to repeated delivery delays, unusual disputes and rumours of suppliers waiting for payment, not because any one of those things proves a financial problem, but because patterns matter.

The relationship between price and financial stability also deserves more attention than it usually receives. Owners naturally negotiate. On a contract worth tens of millions, even a relatively small reduction can represent a huge amount of money, and there is nothing wrong with seeking good value. But a contract that leaves the builder almost no margin can eventually become expensive in other ways.

A yard losing money on a yacht has very little room to absorb mistakes. Every technical change becomes contentious. Every delay hurts. Every variation becomes an opportunity to recover margin. The commercial relationship becomes more aggressive and the project may slowly turn into a three-year argument about who should pay for what.

A financially healthy yacht contract should allow both sides to succeed. The owner receives the yacht promised at a fair and properly controlled price, while the builder makes a reasonable return for accepting the enormous technical and commercial risk involved in delivering it.

That may sound like an obvious principle, yet the industry naturally celebrates full order books without always asking whether the contracts inside them are actually good business.

A yard can have too much work.

It can promise more yachts than its facilities, management and supply chain can comfortably support. Project teams become overloaded, subcontractors are stretched, mistakes increase and delays begin feeding into one another. Overtime rises, quality becomes harder to control and the cost of managing the order book increases faster than expected.

Success itself becomes the problem.

None of this means buyers should be suspicious of every shipyard with a long waiting list. A substantial order book can genuinely be evidence of strong demand, excellent products and financial stability. The mistake is assuming it proves those things on its own.

Busy and healthy are not synonyms.

For an owner choosing where to place a project that may consume four or five years and tens or hundreds of millions of euros, the most important question is not how many yachts the yard has sold.

It is whether the shipyard has the financial strength, management capacity and working capital to build all of them properly.

That question becomes particularly important once your own yacht is halfway through construction. By then, millions may already have been paid, specialist equipment may have been manufactured specifically for the vessel and changing builders may be practically impossible.

A full order book tells you that people want to buy yachts from a shipyard. It tells you that designers are designing, welders are welding and sheds will remain busy.

What it does not tell you is whether the money moving through that shipyard is enough to support all of those promises at the same time.

And in a business where a single unfinished yacht can contain tens of millions of euros of somebody else's money, that difference matters far more than the number of hulls sitting in the shed.
